Sentinel-2 satellite mosaic showing The Line excavation progress across the Tabuk desert, October 2022 — the thin trench visible from orbit marks the foundation work for NEOM's planned 170km linear city

NEOM’s Sixteen-Billion-Dollar Exit Bill

Saudi Arabia budgeted $16 billion to terminate NEOM contracts — more than two-thirds of the project's remaining budget. Why cancelling costs more than continuing.

NEOM — Saudi Arabia has budgeted SAR 60 billion ($16 billion) to pay contractors for terminating NEOM agreements over the 2026–2030 period, Semafor reported on June 7. The kingdom has already spent $64 billion on the megaproject since Crown Prince Mohammed bin Salman unveiled it in October 2017. PIF’s cash reserves — $15 billion, a six-year low — are smaller than the exit bill itself.

Conflict Pulse IRAN–US WAR
Live conflict timeline
Day
101
since Feb 28
Casualties
13,260+
5 nations
Brent Crude ● LIVE
$113
▲ 57% from $72
Hormuz Strait
RESTRICTED
94% traffic drop
Ships Hit
16
since Day 1

The $16 billion is not a penalty in the conventional sense. “Termination for convenience” clauses, standard in Gulf construction contracts, entitle firms to full reimbursement for completed work, demobilization, and early-termination costs. The deeper a project advances before cancellation, the closer the exit cost converges with the completion cost. NEOM’s construction commitment was cut from $71 billion to $30 billion before PIF published its April strategy; the strategy then applied an additional 15 percent capex reduction, bringing the total 2026–2030 allocation to roughly $25.5 billion. Of that, $16 billion — nearly two-thirds — goes to contractors for stopping work. The remainder, approximately $9.5 billion, funds actual construction.

The Cost of Stopping

Semafor’s reporting placed the $16 billion within NEOM’s 2026–2030 budget as “anticipated payments to contractors to terminate long-term agreements.” The final amount may shift — Semafor noted it remains contingent on individual negotiations still underway — but the order of magnitude reflects contractual commitments accumulated during NEOM’s peak construction phase between 2021 and 2024. At least $8.45 billion in specific contract cancellations have been publicly confirmed.

The largest single termination is Webuild Group’s Trojena dam-and-lake contract, valued at $4.7 billion and approximately 30 percent complete at cancellation. Webuild’s Connector high-speed rail contract — €1.4 billion ($1.6 billion), the link that would have connected The Line to Oxagon’s logistics hub — was terminated on May 27, 2026, at roughly 20 percent completion. Hyundai Engineering & Construction confirmed a separate tunnel consortium cancellation was “due to a request for contract termination due to the client’s project restructuring.” Eversendai’s Trojena structural steel contract followed the same path.

“Costs accrued up to the effective date of the termination, as well as those related to the early termination of the contract — including site disengagement and demobilisation activities — will be reimbursed by the client, leaving the Webuild Group unharmed by the effects of the termination.”

— Webuild Group, press release, May 2026

The HOS Daily Brief

The Middle East briefing 3,000+ readers start their day with.

One email. Every weekday morning. Free.

The contractual mechanism governing these exits — termination for convenience — is standard across Gulf construction under FIDIC-based templates. The employer retains an unconditional right to halt work at any stage. The contractor is made whole: work in progress, materials ordered, equipment mobilized, subcontractor commitments, and full demobilization. Webuild’s two cancelled NEOM contracts alone carried a combined face value of $6.3 billion.

Confirmed NEOM Contract Terminations (as of June 2026)
Contract Contractor Value Completion at Termination Source
Trojena dam and lake Webuild Group $4.7B ~30% Webuild, May 2026
Connector high-speed rail Webuild Group $1.6B (€1.4B) ~20% Webuild, May 2026
Tunnel consortium Hyundai E&C Undisclosed Early stage Zawya, 2026
Trojena structural steel Eversendai Undisclosed Early stage ENR, 2026
Confirmed total $8.45B+ Additional terminations pending

Arabian Business noted in June 2026 that “even halting parts of the project will be expensive nearly a decade after Crown Prince Mohammed bin Salman unveiled the development.” The $8.45 billion in confirmed cancellations covers roughly half the total budgeted termination cost, suggesting a comparable volume of settlements either in negotiation or not yet disclosed.

Engineering News-Record described the pattern as “cancelled contracts signal rethink for Saudi Arabia’s $500B NEOM megaproject.” New Civil Engineer, on June 1, characterized it as “further doubts” over the development’s viability. The common thread in the engineering trade press is not surprise at the cancellations but at the contractual exposure they reveal — agreements signed against a $500 billion vision and terminated against a $30 billion reality.

Where Did Sixty-Four Billion Dollars Go?

NEOM was announced in October 2017 with a stated budget of $500 billion — a figure that operated less as a financial projection than as a signal of ambition. Sixty-four billion dollars and nine years later, the gap between announcement and achievement is measured in kilometers. The Line, the mirror-walled linear city that MBS introduced in 2021 as a 170-kilometer structure housing nine million residents, has 2.4 kilometers of completed foundation work.

The original specification called for two parallel structures rising 500 meters — roughly the height of One World Trade Center — and stretching the full 170 kilometers, with no cars, no streets, and all services embedded within the walls. The 2.4 kilometers completed represent 1.4 percent of the total length. An internal audit projection leaked to the Wall Street Journal estimated that completing The Line to its original specification would cost $8.8 trillion and take until 2080.

Construction on The Line was suspended in September 2025 after roughly four years of active site preparation and foundation work. On May 22, 2026, NEOM formally announced the halt would extend “at least until 2030.” The population target — already cut from nine million to 1.5 million — was reduced again to fewer than 300,000. At the rate of progress achieved before the suspension, reaching the original 170-kilometer target would have required decades of continuous construction — a timeline broadly consistent with the WSJ audit’s 2080 estimate.

Trojena, the mountain resort designated to host the 2029 Asian Winter Games, lost its host status in January 2026 when the Olympic Council of Asia postponed the event indefinitely. The dam contract, the structural steel contract, and related components were terminated between March and June 2026. What remains at the site is earthworks and partial foundation infrastructure in a Hejaz mountain valley at 2,600 meters, where average winter temperatures rarely drop below freezing — a location that would have required year-round artificial snow generation.

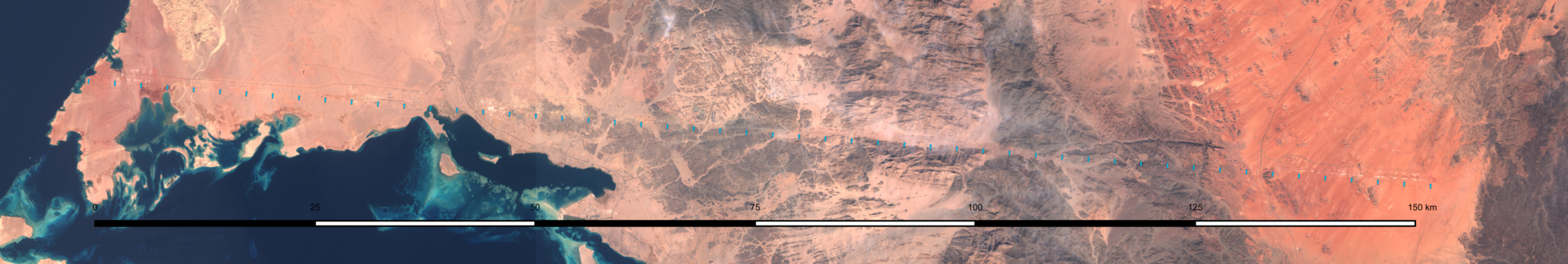

Sentinel-2 satellite mosaic showing The Line excavation progress across the Tabuk desert, October 2022 — the thin trench visible from orbit marks the foundation work for NEOM's planned 170km linear city
Sentinel-2 satellite mosaic of The Line’s excavation corridor across the Tabuk desert, October 2022. The white trench running the full width of the frame is the foundation cut for a structure planned at 170km; 2.4km of that trench has progressed to completed foundation work. Construction was suspended in September 2025. Photo: European Space Agency / CC BY-SA 3.0

Sindalah, the luxury yacht island off NEOM’s Red Sea coast, received no fresh capital allocation in PIF’s 2026–2030 strategy. Its marina infrastructure is partially complete but indefinitely suspended, without a resumption date or a designated funding stream. Sindalah was originally projected to open to guests in 2024, then 2025. It has not opened.

PIF’s 2024 annual accounts included an $8 billion write-down on giga-projects — reported by CNBC in August 2025 as the first formal impairment of Vision 2030 assets. A sub-project allocation was not disclosed. In aggregate, the $64 billion produced foundation work for 1.4 percent of one linear city, partial earthworks for a ski resort in mountains that do not freeze, and a marina without visitors.

What Survives at NEOM?

Oxagon, NEOM’s industrial and logistics zone, is the only component that received fresh PIF capital in the 2026–2030 strategy: $3 billion designated for the green hydrogen facility and port terminal. The hydrogen plant — an $8.4 billion joint venture — was 80 percent complete as of April 2026. The port terminal remains on track for a 2026 opening, targeting 1.5 million TEU of annual container throughput.

The decision to fund Oxagon and nothing else within NEOM reflects a triage articulated through capital allocation rather than public statement. Green hydrogen has offtake agreements and an export market. A container port on the Gulf of Aqaba has a geographic rationale independent of the megacity that was supposed to surround it. PIF Governor Yasir al-Rumayyan told Al Arabiya in April 2026 that “some projects have been delayed because they are not on the critical path.” At least $8.45 billion in contracts had already been terminated when he spoke.

NEOM’s headcount stood at approximately 6,000 at peak staffing, with several hundred direct employees already laid off and 1,000 or more additional reductions under consideration, according to Middle East Eye. Demobilization costs for NEOM’s own workforce — severance, end-of-service benefits under Saudi labor law, visa cancellations for international staff — sit outside the $16 billion contractor budget, which covers external agreements only.

Oxagon’s hydrogen plant and port, completed and operational, would constitute mid-scale energy and logistics infrastructure in the Gulf of Aqaba — viable assets, but bearing little resemblance to the 170-kilometer mirror city, alpine ski resort, and luxury marina that the original $500 billion was designed to build. Of NEOM’s four major announced components, one received funding for 2026–2030.

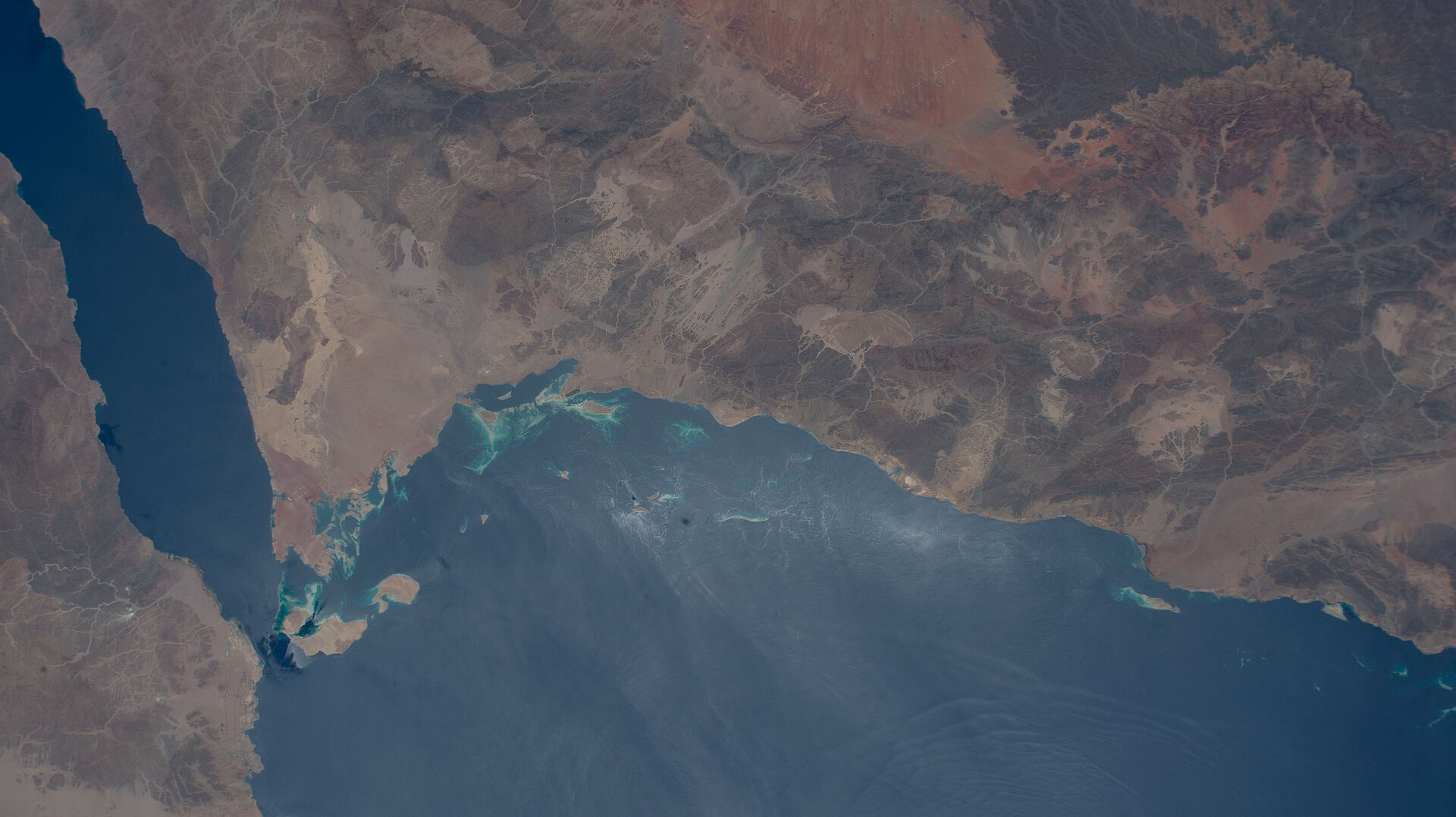

NEOM coastline and Gulf of Aqaba photographed from the International Space Station during Expedition 67, 2022 — the Oxagon industrial zone and port terminal occupy the northwestern Saudi coast where the Red Sea narrows toward the Strait of Tiran
The NEOM coastline and Gulf of Aqaba, photographed from the International Space Station during Expedition 67 (2022). Oxagon’s port terminal and green hydrogen plant — the only NEOM components allocated fresh PIF capital in the 2026–2030 strategy — occupy the coastal strip at the upper left of this frame, where the Gulf of Aqaba meets the Red Sea. Photo: NASA / Public domain

Why Does Abandonment Cost More Than Continuation?

The termination budget exceeds the construction budget. Of NEOM’s $25.5 billion 2026–2030 allocation, $16 billion covers contractor exits for cancelled projects. The remainder, approximately $9.5 billion, funds actual construction, with Oxagon’s $3 billion the largest identified allocation. Nearly two-thirds of what NEOM will spend over the next four years goes to paying firms for work they will not complete.

The $64 billion already spent is irrecoverable regardless of the next decision. Adding the $16 billion termination budget to the pre-existing $8 billion write-down produces $24 billion in combined impairment and exit costs — more than a third of cumulative NEOM investment recognized as loss or unwinding expense. The remaining two-thirds produced 2.4 kilometers of foundation work, partial Trojena earthworks, an incomplete marina, and a hydrogen plant approaching completion.

Full abandonment — terminating every remaining NEOM contract, including Oxagon’s — would push exit costs above the current $16 billion while eliminating the only components with a commercial revenue case. Oxagon’s hydrogen and port contracts are active, the joint venture is funded, and the port’s contractors are mobilized for a 2026 opening. The cost to complete these assets — the $3 billion PIF allocated in April — is a fraction of what cancelling them would add to the termination bill. PIF made the allocation to avoid precisely that outcome.

The trap operates through a mechanism familiar in defense procurement and large infrastructure: the deeper the commitment, the more expensive the exit. Webuild’s Trojena settlement at 30 percent completion reimburses three years of mobilized workforce, imported equipment, subcontractor obligations, and partially constructed infrastructure with no alternative buyer. At 20 percent, the Connector rail settlement follows the same formula at smaller scale. At zero percent, termination costs almost nothing. NEOM passed zero percent years ago.

The calculation is cleaner in outline than in practice. Some contracts may settle below face value where early-stage cancellation limits the reimbursable base. Others — Webuild’s in particular, where the contractor has publicly stated it will be “unharmed” — suggest settlements at or near full contractual exit cost. The final number depends on negotiations that Semafor described as still underway across multiple contractor relationships simultaneously.

PIF at a Six-Year Cash Low

PIF’s cash reserves fell to approximately $15 billion in late 2024 — the fund’s lowest liquidity position since 2020 — as structural pressures on oil revenue compressed the kingdom’s primary funding mechanism. Total assets under management reached $925 billion under the 2026–2030 strategy, but the headline figure overstates the liquid resources available for current-period obligations. Most of the portfolio is locked in illiquid domestic holdings: real estate, infrastructure, early-stage ventures, and the giga-projects themselves.

The 2026–2030 strategy directs roughly 80 percent of PIF’s portfolio into domestic investments, cutting international exposure to 20 percent from a peak of 30 percent. The domestic pivot concentrates capital in long-duration, single-economy assets during wartime. The $23 billion Humain AI portfolio — announced as the primary reallocation destination — draws from the same constrained cash pool that must fund NEOM’s exit payments, Diriyah Gate’s ongoing construction, the Red Sea tourism zone, and the widening Aramco dividend gap.

PIF holds $15 billion in cash. The NEOM termination budget is $16 billion. Humain AI requires $23 billion. Diriyah Gate carries a reported $20 billion price tag and remains under active construction. The Red Sea tourism zone, Qiddiya entertainment city, and the ROSHN housing programme each carry multi-billion-dollar commitments through 2030. The 2026–2030 strategy does not disclose a sequencing priority among these claims beyond the implicit signal of Oxagon’s $3 billion allocation.

PIF’s planned IPO pipeline for 2026 — Sela, Saudi Global Ports, ArcelorMittal’s Jubail steel joint venture, among others — converts illiquid portfolio stakes into Tadawul market proceeds, generating cash to fund priority obligations rather than expanding the fund’s investment footprint. Aramco’s 2024 secondary offering raised $11.2 billion through the same mechanism, demonstrating the structure’s capacity to generate liquidity at scale.

The LIV Golf exit, announced April 29, confirmed that PIF is conducting a return-discipline sweep across its international holdings. The fund invested more than $5 billion in the golf venture over four years. The April strategy listed thirteen domestic priorities for 2026–2030; professional golf was not among them.

The Dubai World Precedent — Without Dubai’s Revenue

The closest Gulf precedent for a sovereign megaproject restructuring is Dubai World’s 2009–2010 debt standstill. The government of Dubai restructured $24.9 billion in Dubai World liabilities and $23.7 billion in Nakheel obligations — a combined $48.6 billion that took until mid-2011 to resolve. Abu Dhabi provided a $10 billion emergency credit facility. The restructuring extended maturities, converted commercial paper to long-dated bonds, and preserved the underlying assets as operating businesses.

Dubai World and Nakheel had revenue. The Palm Jumeirah, the World Islands, the Atlantis resort — these were real estate and hospitality developments funded in part through off-plan sales and visitor income. Revenue flowed before, during, and after the restructuring. Creditors accepted longer timelines because the underlying assets generated cash.

NEOM has no equivalent revenue layer. The $64 billion spent to date is entirely sovereign-funded, with no off-plan sales, no hotel bookings, no port throughput fees, and no lease income offsetting the capital expenditure. Oxagon’s port and hydrogen plant will be the first NEOM components to produce commercial income, and neither has begun operations. Dubai World took approximately eighteen months from standstill declaration to final restructuring terms; NEOM’s termination negotiations are running concurrently across multiple contractors with no announced timeline for settlement completion.

Abu Dhabi’s $10 billion credit facility functioned as a de facto sovereign backstop — one emirate rescuing another’s overextended development arm. PIF has no analogous backstop. The fund is itself the sovereign instrument for Saudi Arabia’s domestic economy, the entity that would normally provide a rescue rather than require one. Saudi Arabia’s gross foreign reserves — approximately $440 billion as of Q1 2026 — are held by SAMA to defend the riyal’s 3.75 SAR/USD peg, and redirecting them toward PIF obligations would carry implications for the fixed exchange rate that anchors the kingdom’s financial architecture.

PIF’s April decision to reclassify NEOM as a “standalone pillar” — separating its financial reporting from the fund’s other domestic portfolios — mirrors the ring-fencing that Dubai applied when it isolated Dubai World’s liabilities from the government balance sheet. The reclassification quarantines NEOM’s termination costs: if the $16 billion overruns, the excess appears within the standalone pillar rather than contaminating reported returns on Diriyah Gate, the Red Sea tourism zone, or the Humain AI portfolio.

The IMF, in its June 3 Article IV, called PIF’s “recalibrated 2026–30 strategy, with its shift toward more selective capital allocation and greater private-sector crowding-in” a “welcome development.” The Fund did not address the termination budget specifically.

Riyadh skyline at sunset showing the Kingdom Tower and King Abdullah Financial District towers under construction — PIF, which manages the fund's $925 billion in assets from this district, held just $15 billion in liquid reserves by late 2024
Riyadh’s King Abdullah Financial District skyline (with cranes still visible during construction), home to PIF’s headquarters. The fund reported $925 billion in assets under management under its 2026–2030 strategy, but liquid cash reserves fell to $15 billion — below the $16 billion NEOM exit bill — by late 2024. Photo: B.alotaby / Wikimedia Commons / CC BY-SA 4.0

How Does the War Change the Arithmetic?

The war with Iran did not create NEOM’s capital trap. The Line’s construction was suspended in September 2025, five months before the conflict began on February 28, 2026. The $71 billion-to-$30 billion construction cut and the $8 billion write-down both preceded the first strike on Saudi territory. PIF’s cash decline to $15 billion was recorded from late-2024 data. The path from $500 billion announcement to $16 billion exit bill was set before the war began.

What the war eliminated was fiscal margin. Saudi Arabia’s Q1 2026 deficit reached SAR 125.7 billion ($33.5 billion) — the largest quarterly shortfall on record, consuming 76 percent of the full-year SAR 165 billion target in ninety days. Military spending surged 26 percent year-over-year to SAR 64.7 billion. Goldman Sachs projects the full-year deficit at SAR 300–330 billion ($80–90 billion), nearly double the official target.

Saudi Arabia Fiscal Snapshot, Q1 2026
Metric Figure Source
Q1 2026 deficit SAR 125.7B ($33.5B) Ministry of Finance
Full-year deficit target SAR 165B ($44B) Official budget
Q1 as share of target 76% Derived
Goldman Sachs full-year projection SAR 300–330B ($80–90B) Goldman Sachs
Q1 military spending (YoY change) SAR 64.7B (+26%) Ministry of Finance
Aramco Q1 dividend vs. free cash flow $21.89B vs. $18.6B Aramco Q1 2026
PIF cash reserves $15B (six-year low) PIF, late 2024

The IMF’s June 3 Article IV consultation — the first to explicitly condition a Gulf state’s diversification outlook on a military conflict — stated that recovery is “contingent on Hormuz normalising over the coming months.” The Fund warned separately that “a prolonged conflict could erode investor confidence and weaken medium-term growth and diversification prospects.”

Aramco’s Q1 dividend of $21.89 billion exceeded its free cash flow of $18.6 billion by $3.3 billion — a structural overpay documented across consecutive quarters. The base dividend funds PIF through the government’s 98.5 percent ownership stake. When dividends exceed free cash flow, Aramco draws down reserves or borrows to maintain the fiscal transfer that underpins PIF’s domestic spending capacity.

The Aramco transfer chain — upstream revenue to government dividend to PIF allocation to domestic deployment — functions only when each link generates surplus above its own obligations. At current oil prices, the chain operates under strain but remains intact. At post-deal prices — the $65–80 range Goldman Sachs and Wood Mackenzie project for a Hormuz reopening scenario — upstream margins would compress to a level where Aramco’s $87.6 billion annualized base dividend consumes cash flow that would otherwise fund maintenance capital expenditure and exploration. Performance-linked dividends, the variable top-up that supplemented the base in profitable quarters, have already been eliminated.

Fitch Ratings affirmed Aramco’s A+ credit rating in 2026 but explicitly assumed no performance-linked payouts through 2028. The Aramco dividend is not a shareholder return in the conventional sense — it is the fiscal transfer mechanism through which oil revenue reaches PIF and, through PIF, reaches Vision 2030. When the transfer shrinks, the projects it underwrites lose their funding pipeline at the source.

OPEC+’s inability to defend prices at levels Saudi Arabia’s combined fiscal and transformation budgets require compounds every other constraint. The NEOM exit payments must be sourced from a fiscal year where the government deficit is tracking at twice the official target, Aramco’s quarterly dividend exceeds its cash generation, and PIF’s liquid reserves are smaller than the termination bill they must cover.

Frequently Asked Questions

What happens to NEOM’s workforce?

Saudi labor law mandates end-of-service benefits calculated at half a month’s salary per year for the first five years of employment and one full month for each subsequent year — obligations that fall on NEOM as the employer of approximately 6,000 at peak. International employees hold company-sponsored iqama work visas with a 60-day departure window upon termination unless a new Saudi employer sponsors them. These workforce costs are separate from the $16 billion contractor termination budget, which covers external construction agreements only.

Could Saudi Arabia sell NEOM’s completed infrastructure?

The Line’s 2.4 kilometers of foundation work — concrete piles and subgrade preparation engineered for a 170-kilometer linear structure — have no secondary market and no alternative application. There is no precedent for reselling partially completed megaproject foundations. Oxagon’s port terminal and hydrogen plant are the only components with transferable commercial value, but PIF has chosen to complete rather than divest them. Sindalah’s partial marina could theoretically attract a hospitality operator, though its remote location and access logistics limit the buyer pool to firms already present in the Red Sea corridor.

How does NEOM’s exit bill compare to other sovereign project cancellations?

Germany’s Berlin Brandenburg Airport exceeded its original €2 billion budget by approximately €8 billion before opening in 2020 — though it was completed, not cancelled. The UK terminated HS2’s northern extension in 2023 after committing an estimated £36 billion, absorbing termination-for-convenience costs structurally similar to NEOM’s. Australia’s East West Link motorway cancellation in Melbourne cost A$1.1 billion in consortium compensation and took three years to settle. If realized in full, the $16 billion NEOM figure would be the largest disclosed single-project termination cost for a sovereign infrastructure programme.

Has Saudi Arabia restructured a megaproject before?

The closest domestic precedent is King Abdullah Economic City (KAEC), a $100 billion development announced in 2005 on the Red Sea coast north of Jeddah. KAEC was projected to house two million residents; in practice, it has operated primarily as an industrial zone and logistics hub with a residential population well below original projections. KAEC was not terminated — it was scaled down incrementally over more than a decade, absorbing smaller annual losses rather than triggering a single large exit cost. NEOM’s $16 billion termination budget reflects a different contracting model: large-scale, long-term construction agreements signed against a $500 billion vision, creating contractual exposure that persists even after the budget was cut by more than 90 percent.
